$1.8T U.S. Construction Industry

Construction Estimating

Software, worksheets, and expert guides for accurate construction estimates — from residential remodels to commercial mega-projects.

Best Estimating Software →

Key Facts

  • The U.S. construction industry reached $2.1 trillion in total spending in 2025, with estimating accuracy directly tied to contractor profitability
  • The global construction estimating software market is projected to grow at 10-13% CAGR through 2030, surpassing $3.4 billion
  • Cloud-based estimating platforms now account for over 73% of new software deployments industry-wide
  • AI-powered takeoff tools reduce quantity measurement time by 70-90% compared to manual methods
  • Construction firms using dedicated estimating software report 15-25% higher bid win rates than those relying on spreadsheets

Construction Estimating in 2026

The construction estimating software market reached $2.38 billion in 2025 and continues to grow at double-digit rates, yet the majority of U.S. contractors still rely on spreadsheets for at least part of their bid process. That gap between available technology and actual adoption defines the state of construction estimating in 2026 — and it explains why firms that invest in proper tools and workflows consistently win more profitable work than those that do not.

Accurate estimating is the foundation of construction profitability. Underestimate and you lose money; overestimate and you lose jobs. The U.S. Census Bureau reports total construction spending exceeded $2.1 trillion in 2025, and every dollar of that work began with an estimate. The industry now relies on specialized estimating software, digital takeoff tools, and AI-powered estimation to replace the manual spreadsheets and guesswork that dominated for decades.

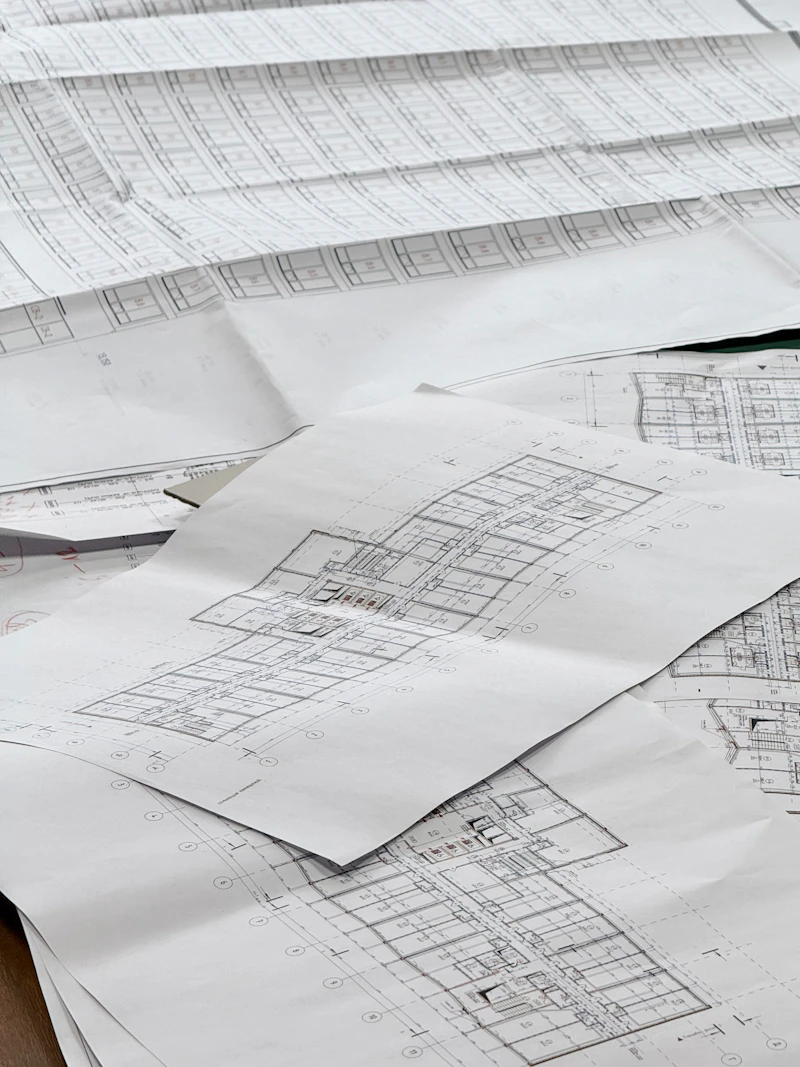

Construction project estimation and planning
Modern estimating combines software precision with construction experience for winning bids

Best Software

Top estimating platforms for GCs and subs.

AI Estimating

How AI is transforming cost estimation accuracy.

Takeoff Tools

Digital quantity takeoff from blueprints and BIM.

Bid Management

Win more jobs with systematic bid processes.

What Is Construction Estimating?

Construction estimating is the systematic process of forecasting the total cost to complete a building project before work begins. It encompasses every expense category: materials, labor, equipment, subcontractor costs, overhead, permits, insurance, and profit margin. The estimate serves as both a financial plan for the contractor and a pricing document for the client. According to the Associated General Contractors of America (AGC), estimating accuracy is the single strongest predictor of project profitability across all construction sectors.

The estimating process follows a defined sequence regardless of project size. First, the estimator reviews the scope of work by examining drawings, specifications, and project documentation. Next comes quantity takeoff — measuring every material and component from the plans. Unit costs are then applied to those quantities using current pricing data from sources like RSMeans or regional supplier quotes. Labor hours are calculated using trade-specific production rates. Finally, the estimator applies overhead allocation and profit markup to arrive at the total bid price. Each step builds on the previous one, and errors in early stages cascade through the entire estimate.

Estimating Process PipelineScopeReview plans &specsTakeoffMeasurequantitiesPricingApply unitcostsMarkupOH & profitappliedSubmitDeliver bidpackageKey checkpoints:Scope: spec cross-reference (48 hr before deadline) | Takeoff: digital vs. manual | Pricing: current supplier quotesMarkup: overhead rate + profit target | Submit: compliance check + required forms + on-time delivery
The five-stage estimating pipeline from scope review through bid submission, with key checkpoints at each stage

The Five Types of Construction Estimates

Not every estimate requires the same level of detail. The Association for the Advancement of Cost Engineering (AACE International) classifies estimates into five categories based on their level of project definition, and understanding when to use each type saves estimators significant time while maintaining appropriate accuracy for each project stage.

AACE ClassNameAccuracy RangeProject DefinitionTypical Use
Class 5Order of Magnitude-50% to +100%0-2%Feasibility screening, capital budgeting
Class 4Schematic / Study-30% to +50%1-15%Concept evaluation, funding approval
Class 3Design Development-20% to +30%10-40%Budget authorization, GMP negotiations
Class 2Substantive / GMP-15% to +20%30-75%Bid preparation, detailed control budget
Class 1Definitive / Bid-10% to +15%65-100%Competitive bidding, contract basis

Residential contractors most frequently produce Class 1 and Class 2 estimates for their bids. Commercial general contractors often start with Class 4 or Class 5 conceptual estimates during preconstruction, then refine through successive rounds as design documents develop. Understanding which class is appropriate prevents the common mistake of spending 40 hours on a definitive estimate when a 4-hour conceptual estimate would have been sufficient for the project stage. For a deeper dive into these methodologies, see our fundamentals guide.

Cost Components Every Estimator Must Track

A complete construction estimate accounts for four major cost categories, each requiring different data sources and estimation methods.

Direct costs are expenses that can be attributed to a specific project scope item. Materials (lumber, concrete, steel, finishes), labor (craft wages plus burden rates for taxes, insurance, and benefits), and equipment (owned or rented machinery) make up the bulk of most estimates. In 2026, material costs remain volatile — the Engineering News-Record (ENR) Building Cost Index showed a 4.7% year-over-year increase through Q1 2026, driven by continued supply chain constraints in specialty steel and electrical components.

Indirect costs cover project-level expenses that are not tied to a single scope item: project management, site supervision, temporary facilities (trailers, fencing, portable restrooms), utility connections during construction, and general liability insurance. These typically add 8-15% on top of direct costs for commercial projects.

Overhead includes the contractor's fixed business expenses — office rent, administrative staff, vehicles, software licenses, professional development, and accounting — allocated proportionally across all active projects. Overhead rates vary widely: small residential contractors may run 10-15% overhead, while large commercial GCs with dedicated preconstruction departments often carry 18-25%.

Profit margin is the contractor's compensation for business risk. According to the Bureau of Labor Statistics (BLS), net profit margins across the U.S. construction industry averaged 6.2% in 2025. General contractors typically mark up 5-15%, while specialty trades with higher risk or specialized skills command 15-25%. Profit should be applied after overhead, not embedded within unit costs, to maintain transparency and allow for strategic bid adjustments.

Trade-Specific Estimating Guides

Each construction trade has unique estimating requirements, production rates, and waste factors. Our trade-specific guides cover HVAC estimating (where ductwork fabrication labor and equipment sizing drive costs), plumbing estimating (where fixture counts and pipe routing complexity determine labor hours), and drywall estimating (where board footage, finishing levels, and ceiling heights create the cost model). For fundamentals that apply across all trades, see our core guide, estimating checklist, and downloadable worksheets.

The Construction Estimating Software Market in 2026

Construction estimating has undergone a significant digital transformation. The global construction estimating software market reached approximately $2.1 billion in 2025 and is projected to grow at a compound annual growth rate of 10-13% through 2030, according to industry analysts. Cloud-based platforms now account for over 73% of deployments, enabling distributed project teams to collaborate in real time from any location — a critical capability for firms managing multiple job sites simultaneously.

AI integration is the defining trend of 2026. AI-powered estimating tools now automate quantity takeoffs, predict cost trends from historical data, and generate conceptual estimates from preliminary drawings in minutes rather than days. Major vendors including Autodesk, Trimble, and Procore have embedded AI modules into their platforms, while specialist startups like Buildxact and Handoff AI target residential builders with accessible, AI-driven estimating workflows.

PlatformBest ForPricing (2026)Key Feature
ProEstCommercial GCs$150-350/user/moBuilt-in RSMeans database
STACKSubcontractors$75-199/user/moCloud takeoff + trade templates
BuildxactResidential builders$149/user/moAI estimator + supplier pricing
Sage EstimatingEnterprise$300-500/user/moAdvanced cost modeling + ERP integration
PlanSwiftTakeoff specialists$1,600 perpetualIndustry-leading PDF takeoff
Autodesk EstimateBIM-integrated firmsIncluded in ACC2D/3D takeoff linked to cost data

For construction professionals evaluating their technology stack, the question is no longer whether to adopt digital estimating — it is how to choose the right platform. Our software comparison guide and best software overview help navigate these decisions.

Why Accurate Estimating Matters More Than Ever

Cost overruns remain the construction industry's most persistent problem. A 2025 study by McKinsey & Company found that large construction projects run an average of 80% over budget and 20 months behind schedule. Material price fluctuations, labor shortages that the BLS projects will leave the industry 500,000 workers short through 2027, and the growing complexity of building codes and sustainability requirements all make accurate estimating more difficult — and more essential — than at any point in the past decade.

Companies that invest in robust estimating processes and technology win more bids at profitable margins. The difference between a 5% estimating error and a 1% error on a $10 million project is $400,000 — enough to turn a profitable job into a loss. Firms using dedicated estimating software with current cost databases, automated takeoff tools, and systematic quality checklists consistently outperform those relying on spreadsheets and institutional memory.

Building Your Estimating System

The most efficient estimating operations share common characteristics: a standardized process documented in a checklist, a current cost database updated at least quarterly, reusable worksheet templates for each project type, and a systematic review process where a second estimator validates critical assumptions before bid submission. Whether you are a one-person residential contractor or a 50-person commercial estimating department, these fundamentals apply.

Start by selecting the right estimating software for your project types and firm size. Layer in digital takeoff capabilities to eliminate manual measurement errors. Implement a formal bid management process to track your pipeline and analyze win/loss patterns. And invest in continuous learning — whether through ASPE (American Society of Professional Estimators) certification programs, university continuing education courses, or the fundamentals resources we provide here. The construction firms that will thrive in 2026 and beyond are those that treat estimating not as a necessary administrative task, but as a core competency that drives every other aspect of business performance. The American Society of Professional Estimators (ASPE) offers the Certified Professional Estimator (CPE) credential for professionals looking to formalize their expertise, and many states now recognize estimating certification as a differentiator in contractor prequalification for public projects.

Frequently Asked Questions

What is construction estimating and why does it matter?

Construction estimating is the process of calculating the total cost of a construction project before work begins, including materials, labor, equipment, overhead, and profit. Accurate estimating is critical because underestimating leads to financial losses while overestimating causes contractors to lose bids to competitors. The AGC identifies estimating accuracy as the strongest predictor of contractor profitability.

How much does construction estimating software cost in 2026?

Construction estimating software ranges from $50-$150 per user per month for mid-market tools like STACK and Buildxact to $200-$500 per user per month for enterprise platforms with BIM integration and AI capabilities. Some tools like PlanSwift still offer perpetual licenses starting around $1,600. Most vendors offer free trials to evaluate before committing.

What is the typical profit margin for construction contractors?

General contractors typically apply 5-15% profit margins, while specialty trade contractors often achieve 15-25% margins. Net profit margins across the U.S. construction industry averaged 6.2% in 2025 according to BLS data, though this varies significantly by project type, region, and firm size.

How is AI changing construction estimating?

AI is transforming estimating through automated quantity takeoffs from blueprints (70-90% faster than manual), predictive cost modeling using historical project data, risk analysis that provides probability ranges instead of single-point estimates, and natural language processing that extracts scope details from specifications. Major platforms including Autodesk, Trimble, and ProEst have embedded AI capabilities into their 2026 releases.

What are the biggest causes of construction cost overruns?

The top causes are incomplete scope review (missing items in the initial estimate), outdated unit pricing that does not reflect current material costs, inadequate contingency allowances, poor change order management, and failure to account for site-specific conditions. McKinsey research shows large projects run an average of 80% over budget, primarily due to estimating and planning failures.

Should I use cloud-based or desktop estimating software?

Cloud-based platforms account for over 73% of new deployments in 2026 and are recommended for teams needing real-time collaboration across multiple job sites. Desktop software still appeals to solo estimators who want full offline capability, though most vendors are phasing out perpetual desktop licenses in favor of cloud subscriptions.

How long does it take to prepare a construction estimate?

A residential remodel estimate typically takes 4-8 hours, a custom home estimate 20-40 hours, and a commercial project estimate 80-200+ hours depending on complexity. Digital takeoff and estimating software can reduce these times by 40-60%. AI-powered tools are further compressing timelines for conceptual and schematic estimates.

What certifications are available for construction estimators?

The most recognized certifications include the Certified Professional Estimator (CPE) from ASPE, the Certified Cost Professional (CCP) from AACE International, and the Certified Construction Manager (CCM) from CMAA. The CPE requires passing two exams and demonstrating at least five years of estimating experience. Certification typically leads to 10-20% higher compensation.

From the field: In 2019, I was finishing up a $3.2M office tenant improvement bid when our estimator realized at 4 PM on bid day that we had missed the raised-access-floor spec entirely — a $40K scope item buried in Division 09 rather than the usual Division 09 66 00 section. We caught it only because a subcontractor called to ask about the floor tile specification, which referenced the access floor system. That incident changed our entire pre-bid process: every project now gets a full spec cross-reference check 48 hours before the bid deadline, not the morning of.

From the field: The first time I used digital takeoff — PlanSwift, back in 2011 — after years of scaling plans with an architect's ruler, the time difference was startling. A 24-page architectural set for a 15,000 SF medical clinic that normally took me 6-7 hours to measure by hand was done in under 2 hours. The real gain was not just speed but consistency: the software tracked every measurement and linked it to a line item, so when the architect issued a revision on sheets A-4 through A-7, I could update only those sheets and the quantities recalculated automatically instead of re-measuring the entire set.

This guide reflects current market data and software pricing as of early 2026. Construction costs, software features, and industry statistics change frequently; always verify pricing with vendors directly before making purchasing decisions. Full editorial policy.

Content verified March 3, 2026

About the Author

Sanjesh G. Reddy — Sanjesh G. Reddy has covered construction estimating since 2007, reviewing estimating platforms, takeoff tools, cost databases, and bid management workflows for contractors ranging from one-person residential shops to multi-office commercial GCs.

Learn more about our editorial team →
